Project Management Week 5 (32541)
Recap on Iron triangle
Does giving extra week to the project change anything in the iron triangle?
we can’t say for certain what will happen. there are many other factors. to just simply determine how the triangle would change.
Time management
Many managers cite delivering projects on time as a major challenge.
Time has very little flexibility.
- Define activities (planning)
- Sequence activities (planning)
- estimate duration (planning)
- develop schedule (planning)
- monitor and control schedule

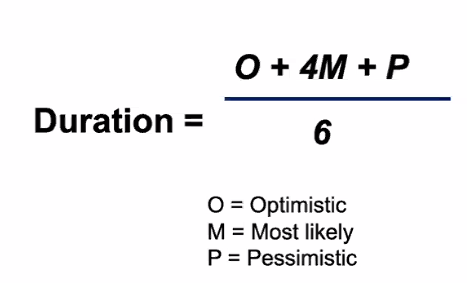

Estimating Task Durations (PERT)
PERT, is a 3 point estimating technique.
Task Dependencies

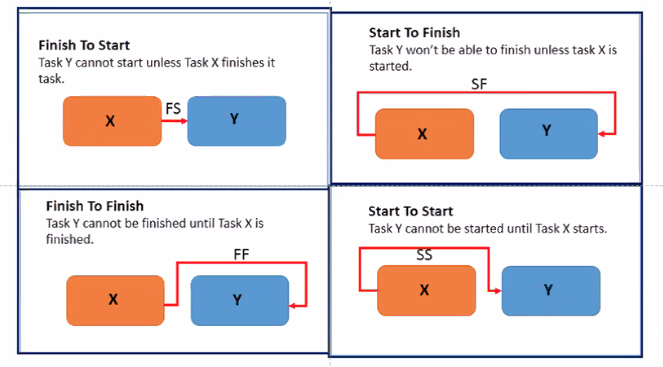

These relationships create dependencies
PERT Diagram
always left to right
finish-start relationship: activity can’t begin until all of its predecessors are complete
arrows indicate flow (time) and should not cross over
Identify with unique number (or letters)
Conditional statements and looping not allowed. (as this indicates that it’s a process instead of a project.)
Critical Path Method

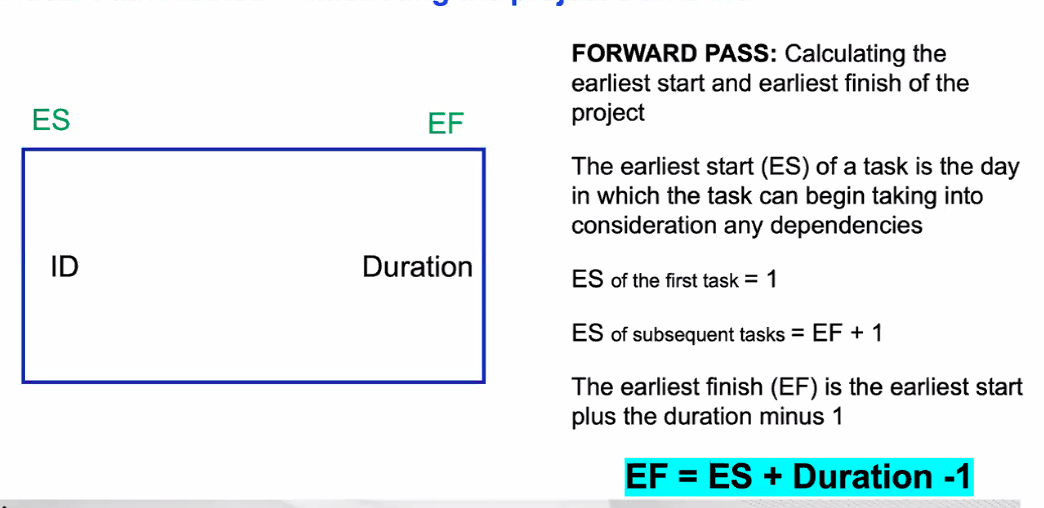

Forward Pass
Backward Pass
Schedule (Time) Management
Process used to ensure the timely completion of project.
Schedule to keep track of the progress.
Time has very little flexibility, it keeps going
Monitoring: comparing with baseline (plans)
Controlling: taking action
